The 30-Day AI Agent Rollout Plan: Shadow, Canary, Scale

Most AI agents die in week 3, not on launch day. Here's the four-stage rollout plan with the go/no-go thresholds that decide whether yours survives

A single thin orange line crossing a dark void, breaking at four marked points

TL;DR

  • 75% of enterprises have already rolled back an AI agent, yet 90% still plan to ship one within the year.

  • The failure mode is almost never the model. It's the absence of a staged rollout with explicit gates.

  • Run four dated stages: shadow week, 10% canary, 50% canary, full traffic — each gated by escalation rate, accuracy delta versus a human baseline, and complaint count.

  • Write the rollback trigger before launch day, not after the first incident.

  • 16% of rollbacks happened because teams could not tell what the agent was doing wrong. Logging is the cheapest insurance you'll buy.

The short answer

An ai agent rollout plan that survives contact with real customers has four stages over roughly 30 days: a shadow week where the agent drafts but a human sends, a 10% canary week with a paired human baseline, a 50% canary across weeks three and four, then full traffic. Each stage has three numeric gates — escalation rate, accuracy versus the human baseline, and complaint count — and a pre-written rollback trigger that fires before anyone has to argue about it in Slack.

That's the plan. The rest of this piece is why each gate exists, what to log at each step, and how to retreat from a bad week without killing the project entirely. If you want the services view of how we wire this, it's there. This piece is the operator's gate-plan.

1. Why agents fail in week 3, not day 1

Launch day looks fine. The agent answers the easy questions, the team celebrates in the channel, and somebody screenshots a good interaction for LinkedIn. Then week three arrives and the volume mix shifts. A new edge case shows up. An upstream system changes a field. The agent starts confidently doing the wrong thing, and nobody notices for four days because nobody set up the dashboard that would have noticed.

That's the actual shape of failure. According to a Sinch survey of more than 2,500 enterprise leaders reported by Customer Experience Dive in October 2025, 75% of enterprises have rolled back an AI agent at least once, while 90% still intend to deploy a customer-facing one within the next year. The same report flagged that 16% of rollbacks were driven specifically by a lack of diagnostics — teams could not tell what the agent was doing wrong, so they pulled it entirely rather than debug it.

Read that sentence twice. The agent wasn't pulled because it was bad. It was pulled because nobody could prove it was good. The deployment gate-plan exists so you never have to make that call blind.

2. Stage 0: Define the rollback trigger before you launch

The most important document in any ai agent pilot to production path gets written before week one. It's one page. It says: here are the three numbers that, if breached, automatically pause the rollout and route traffic back to humans. No meeting required. No debate.

In our client work, the three numbers that earn their keep are usually:

  • Escalation rate above X% over a rolling 24-hour window. Set X to roughly 1.5× the human baseline. If your human team escalates 8% of tickets to a senior, the agent's ceiling is about 12%.

  • Customer complaint count above Y in 24 hours, where Y is calibrated to your normal complaint volume. For a brokerage handling 200 inquiries a day, Y might be 4. For a high-volume support desk, 15.

  • Accuracy delta below the human baseline by more than Z points, measured against a labeled sample of the last 100 interactions. Z is typically 5 points.

Numbers will vary by business. The discipline doesn't. Write them down, get the operations lead and the product owner to sign the page, and wire the alerting before you ship. The piece on why companies are rolling back AI agents walks through what happens when teams skip this step.

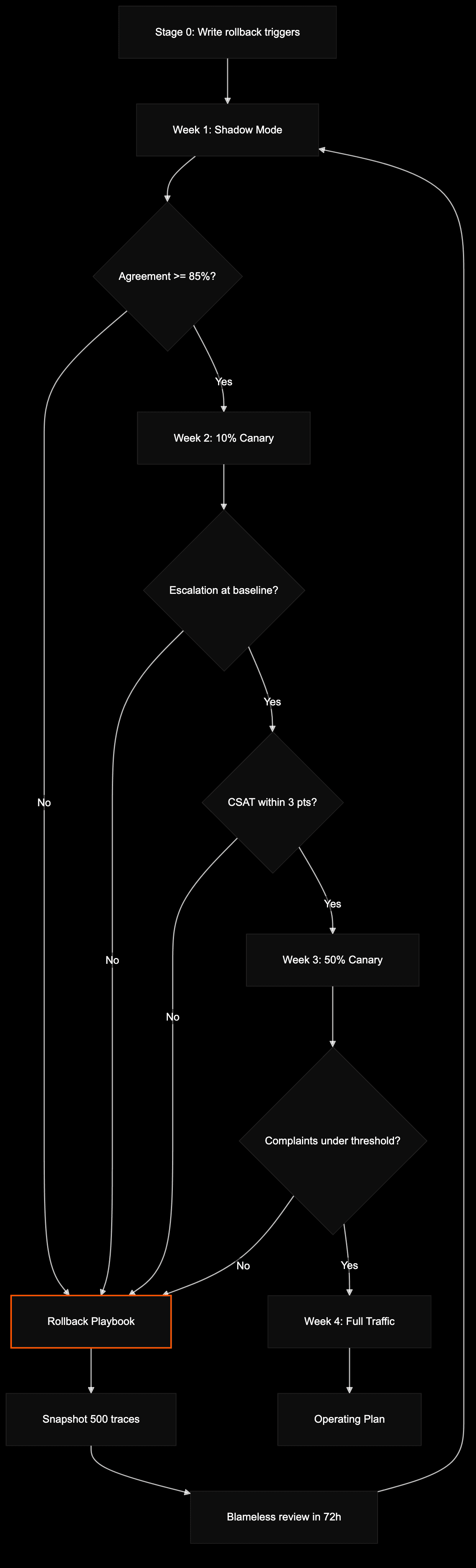

Four-stage rollout flow from shadow mode to full traffic with gate checks and rollback path

Each gate is a numeric check, not a judgment call. Breach routes back to the rollback playbook.

3. Week 1: Shadow mode — the agent drafts, a human sends

Shadow mode is the cheapest week of the rollout and the one most teams skip. The agent sees real production traffic, produces real responses, and writes them to a log. A human reads every one and sends their own version to the customer. The agent's output never reaches the outside world.

What you're measuring this week is not customer satisfaction — the customer isn't seeing the agent yet. You're measuring three things:

  1. Agreement rate. How often did the human send something materially identical to what the agent drafted? Below 70% means the agent isn't ready for canary. Above 85% means you're probably ready to move.

  2. Failure taxonomy. Every disagreement gets a tag: wrong tone, missing context, hallucinated fact, unsafe action, policy violation. By Friday you should have a histogram. The tall bars are your week-two work.

  3. Latency and cost per interaction. If your agent costs more than the human time it would replace, you don't have a product. You have a science project.

Shadow mode is also where the diagnostics get tested. If you can't answer "what did the agent do at 3:42 PM on Wednesday and why" by Friday afternoon, you've recreated the 16% problem from the Sinch report. Fix the logging before you advance.

4. Week 2: 10% canary with a paired human baseline

Now the agent talks to real customers — but only 10% of them, and only on a clearly defined slice (say, password resets and order status, not refund disputes). The other 90% stay on the human path, and that's deliberate. You need a paired baseline running at the same time, on the same traffic mix, to know whether the agent is actually winning or just appearing to.

The gates that block promotion from 10% to 50% are tighter than the rollback triggers. Rollback triggers are the floor. Promotion gates are the ceiling you have to clear:

  • Escalation rate at or below the human baseline. Not 1.5×. At parity.

  • CSAT within 3 points of the human cohort on the same ticket types over a minimum sample of 200 interactions.

  • Zero critical incidents. A critical incident is anything that required a customer apology, a refund the agent shouldn't have issued, or a compliance flag.

This is also the week the shadow mode ai deployment logs become load-bearing. Every canary interaction gets compared against what the shadow version of the agent would have done on the human-handled 90%. That comparison is how you spot drift before it hits the customer-facing slice.

5. Weeks 3-4: Scale-up gates and the metrics that block promotion

Week three moves to 50%. Week four moves to full traffic if — and only if — the gates hold. The temptation at this stage is to declare victory and stop measuring. Don't.

The scale-up phase is where the ai agent canary deployment earns its name. Canaries die first so the miners live. You're watching for the early signal of trouble at 50% before it becomes a full-traffic incident:

  • Rolling 7-day escalation rate trending up by more than 2 points week-over-week is a yellow flag. Investigate within 48 hours.

  • Tail latency at p95 rising above 1.5× baseline suggests the agent is getting stuck in loops on a subset of inputs. Sample those inputs.

  • Cost per resolved interaction rising means you're either hitting more tool calls per ticket or the model is generating longer outputs. Both are debuggable. Neither is debuggable if you didn't log it.

More on the metric set lives in AI agent success metrics. The short version: if you only watch one number, watch escalation rate. It's the closest thing to a single-number health check that an agent has.

Full traffic at end of week four is not the finish line. It's the point where the rollout plan becomes an operating plan. The dashboards stay up. The on-call rotation stays staffed. The diagnostics stay queryable.

6. The rollback playbook: how to retreat without killing the project

A rollback is not a failure. A rollback you can't recover from is a failure. The playbook exists so a bad Tuesday doesn't end the project on Wednesday.

When a rollback trigger fires, the sequence is:

  1. Auto-route traffic back to humans within 60 seconds. Feature flag, not a code deploy. If your rollback requires a code deploy, you don't have a rollback — you have a hope.

  2. Snapshot the last 500 interactions with full traces: input, retrieved context, tool calls, model output, final action. This is the dataset you'll debug from.

  3. Page the on-call. Not the whole team. One person, with a clear runbook.

  4. Post a single status update to the operations channel. What happened, what's paused, what's next, who owns it. No theatre.

  5. Convene a blameless review within 72 hours. The output is either a patch with a re-canary plan, or a documented decision to pause for longer. Either is fine. Silence is not.

The teams that survive their first rollback are the ones that treated it as a planned event with a script. The ones that don't are the ones who treated it as a crisis and let the executive team conclude the whole agent thesis was wrong.

7. What this looks like with real tooling

The stack is less exotic than the marketing suggests. A workable pattern we see in production:

  • Orchestration. n8n or a similar workflow tool for the routing, escalation, and feature-flag logic. See n8n's published pricing page for current tiers.

  • Eval logs. Every interaction written to a structured store with input, retrieved context, tool calls, output, and the human's final action if any. This is what makes diagnostics possible. Without it, you're the 16%.

  • Alerting. The three rollback triggers wired to whatever your team already watches — PagerDuty, Opsgenie, a Slack channel with a real owner. Not email. Email is where alerts go to die.

  • A labeled evaluation set. 200-500 interactions, hand-graded, that you re-run against every model or prompt change before it ships to canary. Without this, every change is a guess.

None of this is novel. All of it is the difference between an agent that ships and an agent that joins the 75%.

FAQ

How long should shadow mode actually run?

One calendar week is the floor, two is safer for higher-stakes use cases. The decision isn't time-based — it's data-based. You need a minimum of about 500 shadow interactions with agreement rate above 85% and a stable failure taxonomy before moving to canary. If your traffic is low, shadow mode runs longer. That's fine.

What's the right canary percentage to start at?

10% is the operator's default. It's enough volume to surface real issues within a week at most ticket volumes, and small enough that a bad day doesn't become a customer-base-wide incident. Below 5% and you won't get signal fast enough. Above 20% and you've skipped the canary stage and called it one.

Do we really need a paired human baseline running during canary?

Yes, for the first canary stage at minimum. Without a concurrent human cohort on the same traffic mix, you can't tell whether the agent's escalation rate is high because the agent is bad or because that week's tickets were unusually hard. The baseline is what makes the comparison honest.

What if our agent fails a gate by a small margin?

Hold at the current stage and investigate before promoting or rolling back. A 1-point CSAT miss at 10% canary isn't a rollback — it's a signal to sample interactions, find the pattern, patch, and re-measure for another week. Promotion is earned, not scheduled. Rollback is for hard-trigger breaches, not soft misses.

Who owns the rollback decision in practice?

One named person, decided before launch. Usually the operations lead for the affected workflow, not the engineering lead and not the executive sponsor. The rollback triggers are pre-agreed numbers, so the owner's job is to confirm the breach and pull the flag — not to relitigate whether the thresholds were right. That conversation happens in the post-incident review.

Where to start this week

Pick the one workflow where you already know the failure cost of a bad agent response, and write the one-page rollback trigger document for it. Three numbers, two signatures, one owner. Ship that by Friday, and you've done more than most teams do in their entire pilot.

If you want a second pair of eyes on the gate-plan before you launch, tell us what you're rolling out.
